Enugu – Onitsha expressway (Onitsha bound)
CONSULTANT’S REPORT: Crown Crest Global Engineers Ltd (CCGE)
Date: June 01, 2025 Location: Enugu – Onitsha expressway (Onitsha bound)
Subcontractor: RCC ANAMBRA
Activities conducted:

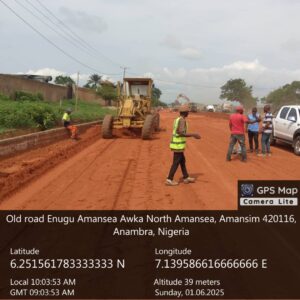

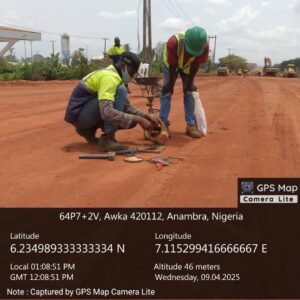

- 1. Insitu-density test of filling material from borrow pit CH 25+850 – CH 25+600 Av relative compaction=101%

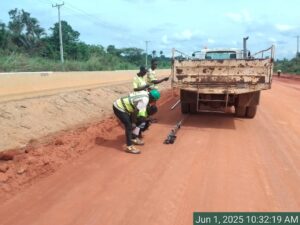

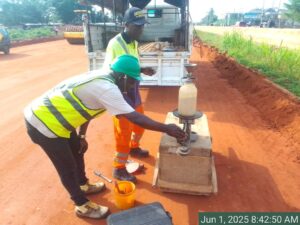

- 2. Deflection test of Sub grade final CH 27+275 – CH 27+125

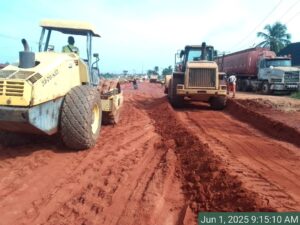

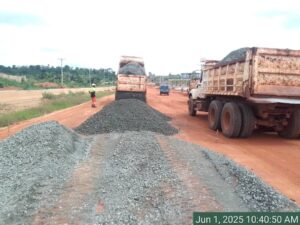

- 3. Laying of stone base material 1st layer CH 29+200 – CH 29+000(the stone base material is laid on where the soil cement stopped before their resumption now)

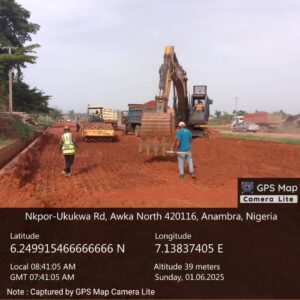

- 4. filling of borrow pit material for sub grade levelling and compaction in progress CH 25+525 – CH 25+425.
